Photos – Mike Strope, Herons Glen
If you’ve driven South on US 41 lately, you’ve probably noticed the massive construction activity across from Peaceful Pines Trailer Park and the Encore Sunseekers RV community. There is a mass of heavy equipment activity in the ditch along the highway and enormous sections of pipe staged. So, what exactly is going on down there?
Project at a Glance
- Pipeline: 3+ miles of 36-inch diameter water pipe is being buried in the ditch along US 41
- Estimated completion: Mid-2027
The answer to the question is that the City of Cape Coral is in the middle of one of the most significant water infrastructure investments in its history. For nearly a decade, the City was pumping water from the former Southwest Aggregates Mine’s gravel-pit property in Charlotte County directly into the drainage ditch running alongside US 41. The water flowed naturally southward into Cape Coral’s canal network.
The city has realized that there are limitations in using this open-ditch method. Evaporation, flow rates were uncontrolled and difficult to measure plus just the reliability of the water flowing. The city sought to address these with a permanent solution.
A $38 Million Property Purchase

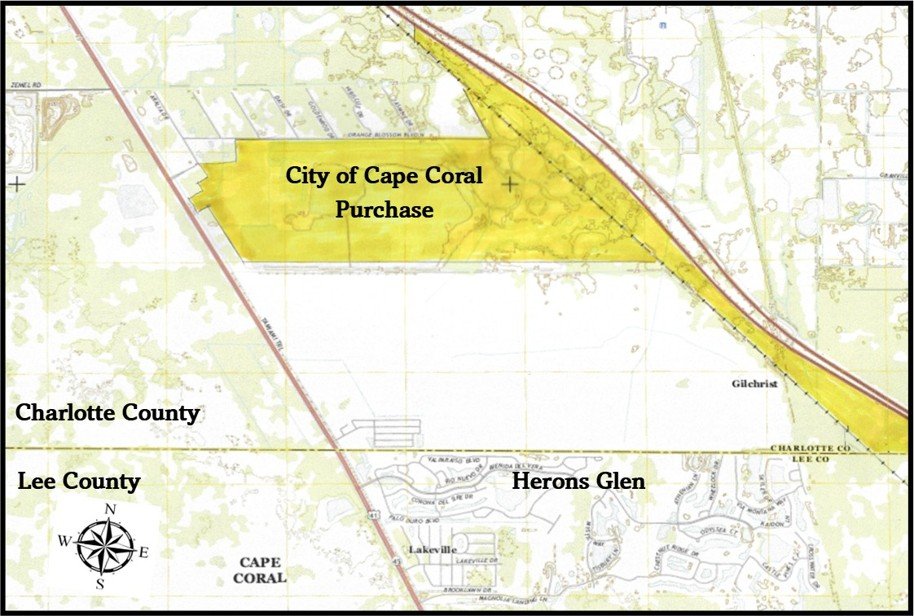

In October 2024, Cape Coral purchased the former Southwest Aggregates Mine property consisting of about 1,200 acres for $38 million. See the map of the purchase property accompanying this article. What makes this acquisition so strategically valuable is the old gravel pits, now filled with freshwater. These form a natural deep-water reservoir covering 570 acres and holding an estimated 1.5 billion gallons of freshwater. Since Cape Coral continues to be one of the fastest growing cities in the United States, the additional water will nearly double the dry-season water delivery and more reliably.
What’s Actually Being Built
The construction activity is the installation of a 36-inch diameter water transmission pipeline being buried and is running approximately three miles southward from those gravel pits along US 41 in the existing ditch. 36 inches in diameter will move enormous volumes of freshwater for Cape Coral’s use.
Also. A new pump station is being constructed at the source to pump freshwater from the gravel pit south through the pipeline at rates of up to 20 million gallons per day. The pipeline terminates at Gator Slough near the Dollar General on US 41 where the water enters Cape Coral’s existing canal network.
What it Means for Herons Glen
For Herons Glen residents, eventually what you see South of Herons Glen will be in front of the community. A few practical realities worth keeping in mind: construction traffic, noise, and the general disruption of heavy equipment operations along US 41. We’ve been unable to find a timeline for the progression of the work, but it is planned to continue through approximately mid-2027. The good news is that once the pipe is buried and the new pump station is operational, the project essentially disappears. The entire system operates underground and out of sight.
Sources
1. City of Cape Coral Official Announcement — Major Regional Water Supply Project Update” (January 2025): facebook.com/CityofCapeCoral
2. Cape Coral Utilities Master Plan, Chapter 6 — Water Resources (Project #6220-02), AECOM, November 2022: capecoral.gov
3. Charlotte County Property Ownership Map — Charlotte County GIS
